Page last updated on:
Project Description
Several new buildings will be constructed in Fairhaven. The private development includes three buildings – one residential, and two residential and commercial – that will sit atop a large parking garage on the property at the northwest corner of Mill Ave and 11th Street, commonly called “The Pit.”
The buildings are expected to offer nearly 200 residential units – a more precise number will be provided as development progresses.
Public Benefits
The project includes a development agreement that allows for an increase in height limits to four stories for parts of the property – it is generally set at three. The City agreed to the increase as long as certain public benefits are included in the project:
- Adding 80 public parking spaces in the private garage with at least five equipped for electrical vehicle charging.
- Allocating 20 percent of units as affordable housing for 12 years.
- Dedicating a permanent easement for the South Bay Trail, an outlook towards Bellingham Bay and view corridors and pedestrian connectivity through the site.
Construction Impacts
See “Project Timeline” below for estimated dates associated with impacts.
Trail Access and Reroute

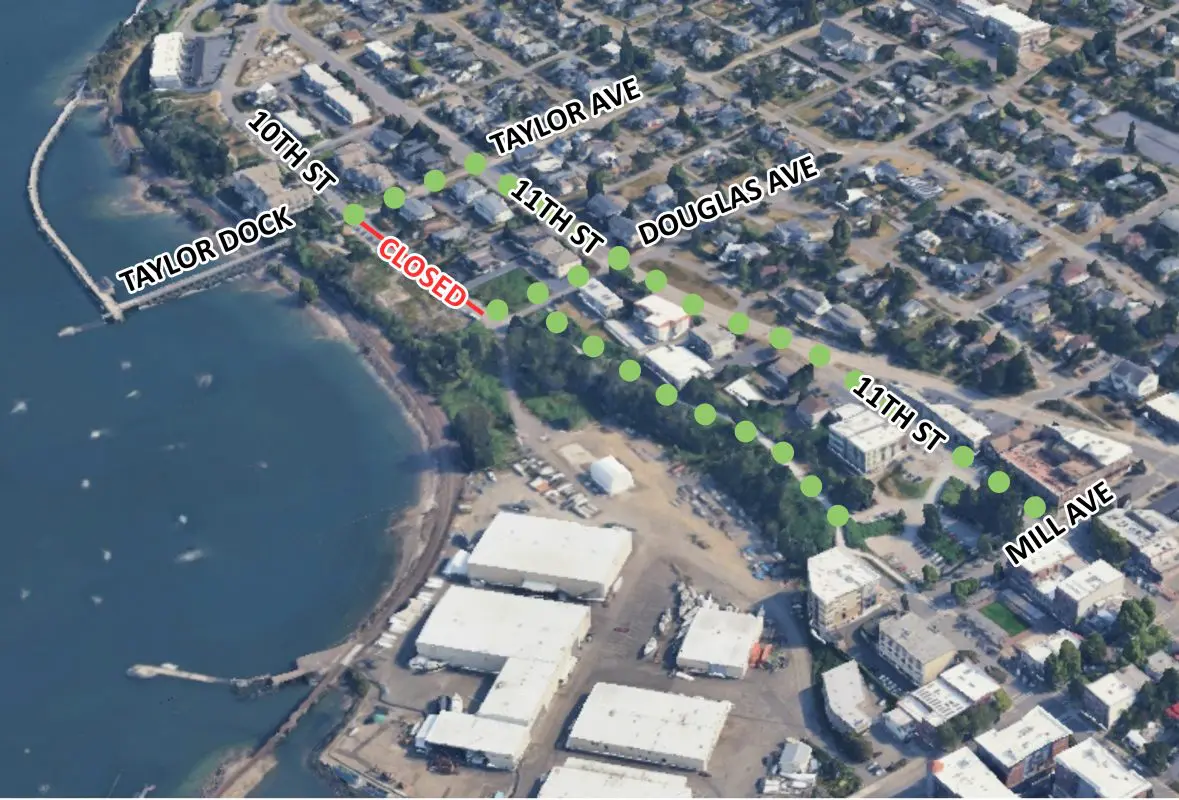

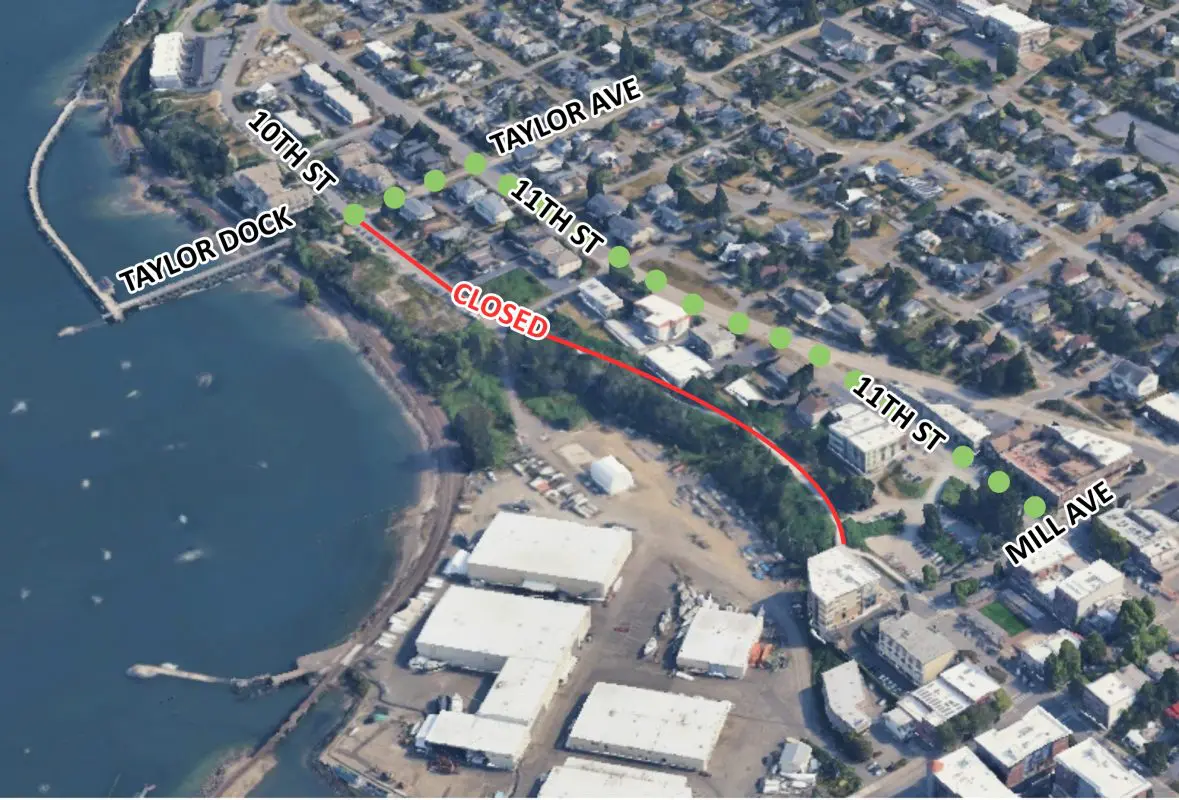

- The South Bay Trail, which runs through the developer’s property, will be temporarily closed between the intersections of Douglas Avenue and 10th Street, and Mill Avenue and 10th Street. It will then be reopened near its original location.
- Construction on 10th Street near Taylor Dock will close another section of that street.
- Alternative routes will need to be utilized by trail users during the closure.
Temporary Recreational Connection Between Fairhaven and Taylor Dock
In addition to the Fairhaven Center project, other construction on 10th Street will affect pedestrian and bike traffic.
Closure and Routes Before Fairhaven Center Project Begins: This closure is expected to begin September 2025.

Closure and Routes When Fairhaven Center Project Begins: The date of this closure is not yet known. This webpage will be updated when a timeframe is determined.

Street, Sidewalk and Parking Access
- For years, the property owner allowed people to use the area as a parking lot. The open pit parking will be used for construction vehicles and equipment.
- During the first phase of the project, the developer may request periodic use of on-street parking areas for limited time periods. The City will consider these requests, and if approved, signage will be posted on the site in advance of closures.
- During the second and third phases, parking at Mill Avenue and 11th Street may be impacted. It is possible for the developer to request a closure of on-street parking for up to 2 years.
Project Timeline
Dates and information will be updated as construction progresses.

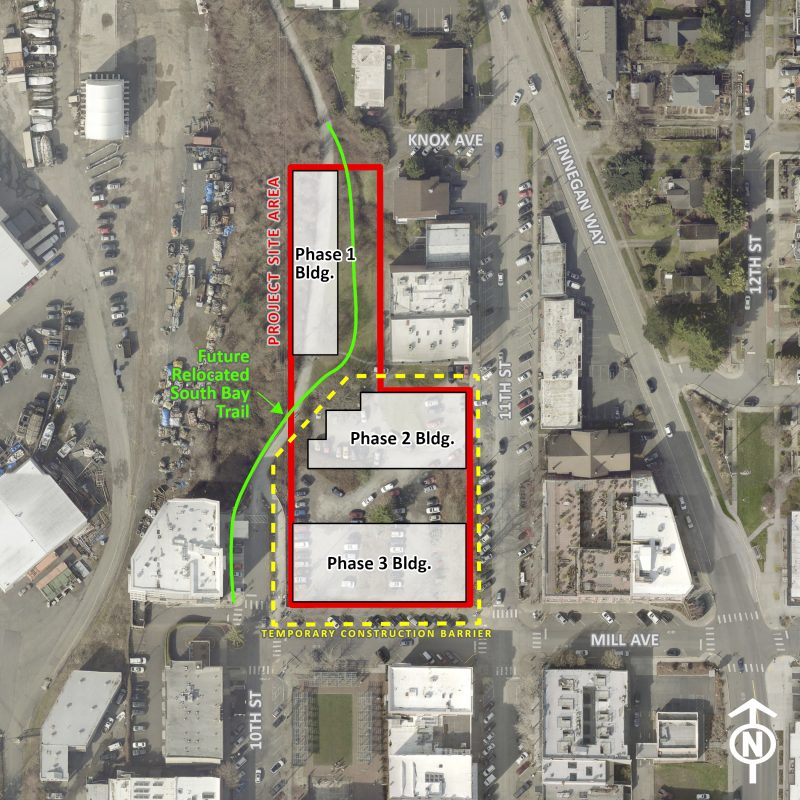

Phases of Construction

Phase 1 – Est. Fall 2025 through Summer 2026
|
Activity 1335827_05a99c-be> |
Estimated Timeframe 1335827_28f234-75> |
Potential Impacts 1335827_804ee2-97> |
|---|---|---|
|
Utility work 1335827_26d337-75> |
Fall 2025 – Completion 1-1.5 years from start date 1335827_1492f2-cc> |
|
|
Construction of the first building 1335827_b94e95-55> |
Winter 2026 – Completion 1-1.5 years from start date 1335827_b746b6-8d> |
|
|
New trail will be constructed 1335827_5d1926-67> |
Winter 2026 – Completion 1-1.5 years from start date 1335827_8e2f4e-43> |
|
Phase 2 – Est. Summer 2026 through Winter 2028
|
Activity 1335827_9ee72d-d0> |
Timeframe 1335827_cd6d52-34> |
Potential Impacts 1335827_b8fa62-62> |
|---|---|---|
|
Development of underground parking garage and second building 1335827_6a36e5-d0> |
Est. Summer 2026 – Winter 2028 1335827_aac4a5-6f> |
|
|
Construction of new sidewalks abutting the 10th Street parking area 1335827_978620-c0> |
Est. Summer 2026 – Winter 2028 1335827_f99bd3-cd> |
|
|
Installation of parking on Mill Avenue and 11th Street 1335827_b3d7b5-b0> |
Est. Summer 2026 – Winter 2028 1335827_447548-30> |
|
Phase 3 – Est. Late 2028 (or later) through 2029 or 2030
|
Activity 1335827_8b0da6-d3> |
Timeframe 1335827_5a3bc0-0e> |
Potential Disruptions 1335827_1255e2-3b> |
|---|---|---|
|
Development of third building 1335827_0d609f-d1> |
Est. late 2028 or later – 2029 or 2030 1335827_a79c2f-8f> |
Parking on 11th Street may be temporarily impacted 1335827_2c331c-34> |
